PCB manufacturing PCB manufacturing
Home > Blog

How Do We Manufacture a Reliable Infusion Pump PCBA?

November 10th, 2026

An infusion pump PCBA is the assembled circuit board that connects the pump’s processor, motor drive, power supply, sensors, alarms and user interface. It does not determine safe drug delivery by itself; reliability depends on the approved circuit design, controlled assembly, documented inspection, agreed board-level tests and final verification inside the complete pump. At EBest Circuit (Best Technology), we manufacture and assemble these boards to customer-controlled files while maintaining the material, process and test records specified for the project.

Infusion pump PCBA connected to pump drive mechanism inside an unbranded enclosure

What Is an Infusion Pump PCBA?

The manufacturing package distinguishes the bare infusion pump PCB from the finished assembly. The fabrication drawing defines the board structure, while the BOM, placement data, assembly drawing, firmware-loading instruction and test specification define the populated infusion pump circuit board. Depending on the device architecture, one PCBA may combine the controller, pump drive, sensor inputs, display and alarm circuits, or these functions may be divided among control, power and interface boards.

Those approved files define our manufacturing scope: PCB fabrication, component sourcing, SMT and through-hole assembly, solder-joint inspection, programming and agreed board-level tests. Pump architecture, software, alarm logic, clinical performance and final device release remain in the customer’s controlled design and verification package.

What Functions Does the Infusion Pump PCBA Support?

The board converts commands and sensor feedback into controlled electrical actions. A typical infusion pump control board may read flow, pressure, door, position or air-in-line sensors; drive a motor or actuator; manage mains and battery power; operate the display and keypad; and activate visual or audible alarms. The actual functions depend on the pump type and the customer’s system design.

Functional blockPCBA responsibilityDesign input we need
Main controlProcess sensor inputs and issue drive, display and alarm commandsApproved schematic, processor, clock, memory and programming requirements
Pump driveSwitch motor current and return position or movement feedbackMotor type, voltage, current profile, connector and load condition
Sensor interfaceCondition and digitize pressure, position, door, flow or air sensor signalsSensor type, range, excitation, interface and fault-state definition
Power managementRegulate rails, charge or monitor the battery, and supervise power transitionsInput range, battery chemistry, rail limits, peak load and protection strategy
HMI and alarmsConnect display, keypad, indicators and audible alarm hardwareDisplay interface, keypad circuit, indicator loads and alarm-output requirements
CommunicationsProvide service, network or peripheral interfaces where specifiedProtocol, isolation, connector, cable and EMC requirements
Infusion pump PCBA hardware regions for power motor drive sensors and display alarm interface

How Do Pump Type and Use Environment Change the PCBA?

A syringe pump, volumetric pump, ambulatory pump and patient-controlled analgesia pump do not impose the same board requirements. A syringe mechanism may emphasize precise motor position and force feedback. A volumetric or peristaltic design may use different drive loads, door detection and pressure sensing. A battery-powered ambulatory pump places more weight on low-power operation, charging, mechanical size and repeated power transitions.

The intended use environment also changes the manufacturing package. Portable equipment may require stronger connector retention and more attention to shock and vibration. Equipment used near other medical electronics needs an EMC plan for the complete enclosure and cable set. Cleaning agents, humidity, storage temperature and expected service life can affect laminate, coating, connector and marking choices. These conditions should be stated in the design input rather than inferred from the phrase ā€œmedical PCBA.ā€

Pump or environmentBoard-level emphasisInformation to define before quotation
Syringe pumpMotor position, force or pressure feedback, compact drive pathMotor and sensor interfaces, peak current, connector cycling
Volumetric pumpMultiple sensors, door status, actuator control and alarm outputsSensor list, fault states, harness map and mechanical keepouts
Ambulatory pumpBattery operation, low-power states, small outline and impact resistanceBattery pack, charging architecture, enclosure constraints and duty cycle
PCA pumpUser-input interface, event logging and alarm hardware defined by the device designKeypad/display interfaces, memory, communications and access-control hardware
Hospital environmentEMC, cleaning exposure, serviceability and traceable configurationApplicable device standards, cleaning agents, cable set and service plan

Infusion Pump PCBA Project Controls vs Standard PCBA Controls

The meaningful difference comes from the controls attached to the order, not from a broad medical-versus-consumer label. The same SMT processes may be used, but specified change approval, traceability, programming, functional testing and record retention add engineering, material-control and documentation work. These requirements must appear in the purchase and quality package before we plan the production route.

Project requirementStandard PCBA controlInfusion pump project control when specifiedEffect on production and quotation
BOM and AVL changesUse approved purchasing rules and listed alternatesSubmit the proposed manufacturer part number and supporting data for customer approval before useAdds sourcing review and may hold material release until approval
Material traceabilityLink the shipment to a production lotLink the work order or board serial to PCB lot, component manufacturer, lot/date code and incoming statusAdds data capture, labeling and record retention
ProgrammingLoad the released file and record a pass resultControl firmware version, programming method, test-software revision and board identityAdds version control and serial- or lot-level records
Functional testingRun a general power-up or interface screenApply customer-defined sensor states, motor loads, alarm outputs and acceptance limitsAdds fixture, software, cycle time and validation work
Inspection evidenceRetain production inspection results according to the standard orderProvide the agreed SPI, AOI, X-ray, programming or test references with the shipment or lot recordAdds report generation, review and delivery requirements
Deviation controlFollow the standard nonconformance and rework processIdentify affected boards or lots and obtain the approval defined by the project before dispositionAdds segregation, review and approval time

How Should Power and Battery Circuits Be Partitioned?

Power input, battery charging, motor drive and sensitive measurement circuits should not be treated as one undifferentiated copper area. The layout needs intentional current-return paths, sufficient copper for peak motor current, clearance around switching nodes and physical separation from low-level sensor inputs. Brownout supervision, reverse-polarity protection, overcurrent protection and battery switchover belong to the customer’s circuit design; manufacturing must preserve the specified creepage, copper geometry and component orientation.

During DFM review, we check whether copper weight, trace width, thermal relief, via structure and connector footprint are manufacturable. If a compact layout requires blind or buried vias, our HDI and special PCB capability can be reviewed against the actual stack-up. HDI should be selected because routing and interconnection require it, not simply because the device is small.

How Are Motor, Sensor and Alarm Circuits Integrated?

The motor path carries changing current, while pressure, position and other sensor paths may carry much smaller signals. Placement should keep high-current switching loops short and maintain the grounding and filtering shown in the approved design. Connector keying, polarity, retention and cable exit direction also matter because a correctly assembled board can still fail integration if a harness is reversed, strained or routed across the pump mechanism.

Alarm hardware needs a testable interface. The PCBA can be checked for buzzer drive, indicator outputs, display response and defined input-state recognition, but those checks do not prove that every device alarm is clinically adequate. The customer supplies the test limits and expected response for each simulated state; we build the fixture and test sequence only to the agreed scope.

How Do We Control Noise and EMC at Board Level?

Board-level EMC control starts with the approved stack-up, return paths, placement and filtering. Motor drivers, switching regulators, clocks and display interfaces can couple noise into sensor or communication circuits. Short current loops, continuous reference planes, controlled connector transitions, input filtering and appropriate separation reduce risk before the assembly reaches enclosure-level testing.

We can manufacture controlled-impedance FR4 structures and inspect the board against the supplied stack-up and coupon plan. The acceptance limits depend on the specified impedance and test method. Cables, enclosure, grounding, power adapter, firmware states and connected accessories are then evaluated in the customer’s complete-device EMC test.

Detailed Infusion Pump PCBA Manufacturing Parameters

For an infusion pump PCBA project, we evaluate the PCB structure and assembly requirements as a complete build. The achievable combination depends on the stack-up, copper weight, board thickness, hole structure, component package, board size and test requirements. We confirm these items together before production.

Manufacturing itemOur manufacturing capabilityProject confirmation required
FR4 layer countUp to 32 layersFinished thickness, stack-up, via type and material availability
Standard minimum line/space4/4 milCopper weight, local density, impedance and yield review
HDI minimum line/spaceDown to 2/2 milSpecific HDI structure, copper, panel and engineering approval
Minimum finished hole0.20 mm standard; 0.10 mm HDIAspect ratio, plating, stack-up and hole type
Smallest listed SMD01005Pad design, stencil, package supply format and inspection plan
Minimum listed BGA pitch0.25 mmPackage drawing, pad geometry, X-ray criteria and rework policy
Assembly methodsSMT, THT and mixed assemblySelective/wave/manual process, heat-sensitive parts and fixture needs
Component supply formatsReel, cut tape, tube, tray and loose partsPackaging condition, feeder suitability, quantity and traceability
Inspection options3D SPI, AOI and X-ray among available controlsWhich packages and defects each inspection must cover

For a conventional controller, our FR4 PCB manufacturing route may provide the required multilayer structure and controlled impedance. A capability value only shows what may be manufacturable; it does not establish the needed layer count, copper, hole size, package pitch or acceptance criterion for a particular pump.

How Do We Manufacture and Inspect an Infusion Pump PCBA?

Our PCB assembly service converts the approved BOM, placement data, assembly drawing and process instructions into a controlled production route. The sequence can include incoming material verification, solder-paste printing, 3D SPI, SMT placement, reflow, AOI, X-ray for hidden joints, through-hole assembly, cleaning or drying where specified, functional testing and final inspection.

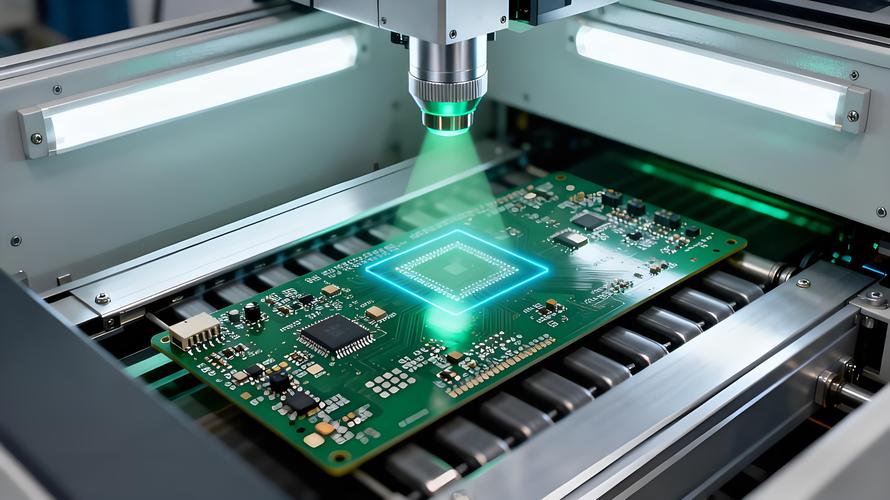

Each inspection has a defined job on the pump board. SPI checks paste deposits before placement; AOI evaluates visible polarity, placement and solder features around control, sensor and alarm circuits; X-ray can examine hidden joints beneath fine-pitch controllers, drivers or bottom-terminated power packages. We match the inspection method to the actual package and failure mode, then use electrical or functional testing for conditions that optical inspection cannot detect.

Infusion pump PCBA on an inspection fixture with AOI and X-ray review

How Is Component and Lot Traceability Maintained?

Traceability starts before placement. The purchase package should define whether records must link the finished serial or lot to the PCB lot, component manufacturer, manufacturer part number, supplier, date code, incoming status, work order, process route and test result. We source through manufacturers and recognized distributors where applicable, and we apply the approved AVL and substitution rules supplied for the project.

A substitution is not accepted merely because the package and nominal value match. For an infusion pump, tolerance, temperature behavior, lifetime, qualification status, firmware compatibility and supply-chain change control may matter. When a specified part is unavailable, we present the candidate and supporting data for customer review rather than silently changing the BOM.

For projects that require a linked evidence package, we can organize the following records around the work order, production lot or board serial number. The purchase package defines which records are delivered and how long they are retained.

Evidence itemLinked fieldsWhat the customer can verify
Material issue recordWork order, PCB lot, manufacturer part number, component lot/date code, supplier and incoming statusWhich approved material lots entered the build
SPI, AOI or X-ray recordBoard lot or serial, inspection program revision, station, result and image/report referenceWhich inspection setup and result applied to the board or lot
Programming recordBoard identity, firmware revision or hash, programmer and programming-software revision, result and timestampWhich released code was loaded and whether programming passed
Functional-test recordBoard identity, test-specification revision, fixture revision, test-software revision, measured values and pass/fail resultWhich limits and test configuration produced the recorded result
Deviation or change recordNCR or ECN reference, affected serials/lots, approval and final dispositionWhether a departure from the released configuration was authorized

What Testing Should Be Defined for Infusion Pump PCBA?

Testing should be derived from the board’s actual interfaces and failure risks. Bare-board electrical test checks continuity and isolation against the netlist. Assembly-level tests can confirm power rails, current consumption, programming, communications, motor outputs, sensor-input simulation, display response and alarm outputs. The customer defines limits, stimuli and pass/fail behavior; we confirm fixture feasibility and record format.

Test or inspectionWhat it can confirmWhat it cannot prove alone
Bare-board electrical testNet continuity and isolation against supplied dataComponent function or finished pump performance
SPI / AOIPaste deposition and visible assembly conditionsHidden electrical behavior or dosing accuracy
X-raySelected hidden solder-joint and void conditionsSoftware, sensor calibration or system reliability
Power-up testInput current, rail voltages and basic protection behaviorAll operating modes or battery endurance
Functional fixture testDefined motor, sensor, display, communication and alarm interfacesComplete fluid path, clinical workflow or device compliance
Device-level verificationFlow accuracy, alarms, EMC, battery operation and essential performance under the device planThis remains the device manufacturer’s controlled validation activity

Example: Customer-Approved Sensor Fault Simulation

A board-level verification sequence can use a sensor interface and fault state already defined in the customer’s test specification. We do not invent the fault threshold; we translate the approved normal, open, short or out-of-range condition into controlled fixture inputs.

  1. Lock the inputs. Record the board revision, BOM revision, firmware revision, test-specification revision, fixture revision, supply condition and approved sensor states.
  2. Apply the stimulus. Drive the specified sensor input through its normal state and the customer-defined fault condition while the board operates under the stated supply and load.
  3. Observe the required outputs. Capture only the signals named in the test specification, such as the processed sensor value, diagnostic flag, alarm output, display or communication code, and motor-enable state.
  4. Judge the result. Compare measured voltage, current, logic state and response time with the approved limits. A missing, late or out-of-limit response fails the board-level test.
  5. Preserve the evidence. Store the board serial or lot, all controlled revisions, measured values, pass/fail result, timestamp and any exception reference in the test record.

This sequence demonstrates that the assembled board responds correctly to the specified electrical fault input. The device manufacturer then verifies the same fault through the complete sensor, fluid path, software, alarm presentation and clinical-use conditions.

Infusion pump PCBA functional test fixture with motor sensor display and battery interfaces

How Do Prototypes Move into Repeat Production?

A prototype proves that the selected materials, footprints, assembly route and test access can be built, but repeat production also needs a stable configuration. Before transfer, unresolved DFM and DFA findings should be closed, the BOM and AVL frozen for the intended build, and the sensor-simulation harness, motor load, alarm checks, programming files and test revisions released under control. Workmanship criteria and approved deviations must also be linked to the affected lot.

For later orders, we compare the released revision, customer-supplied material status, component availability, process instructions and fixture version before production. Any approved change should identify the affected board revision and effective lot. This keeps an earlier prototype decision from becoming an undocumented production change.

Infusion Pump PCBA FAQs

Is an infusion pump controller the same as an infusion pump PCBA?

Not necessarily. The infusion pump controller may refer to the complete control function, including firmware, display, sensors, motor and enclosure interfaces. The PCBA is the physical assembled board that implements part or all of that controller.

Can you source components as well as assemble the board?

Yes. We support consigned, partial-turnkey and full-turnkey assembly. For component sourcing, identify approved manufacturers, alternates, date-code or traceability requirements and any parts that the customer will supply.

Can a prototype test setup be reused for production?

Only after the fixture hardware, connector map, simulated loads, test software, controlled revisions, limits and record format are released for repeat use. A prototype bench setup may demonstrate access to the required signals, but it does not automatically provide repeatable measurements or traceable production results.

Which documents should accompany production boards?

The required package is project-specific. It may include shipment traceability, material or conformity records, inspection summaries, programming versions and functional-test results. The customer should define the exact deliverables and retention period before production release.

What Should You Include in an Infusion Pump PCBA RFQ?

A useful RFQ defines the board, assembly, testing and documentation together. Gerber files alone cannot show component sourcing rules, programming, sensor simulation, fixture interfaces or the records required at shipment. Send the package early enough for us to identify missing design inputs before price and delivery are fixed.

RFQ itemInformation to provideWhy it affects quotation
PCB dataGerber or ODB++, drill files, netlist, stack-up and fabrication drawingDefines materials, geometry, test and board process
Assembly packageBOM, AVL, centroid data, assembly drawing and polarity notesDefines sourcing, placement, feeders, tooling and inspection
ProgrammingDevice list, files, version control and security procedureDefines programming equipment, access and records
Test specificationInputs, loads, limits, pass/fail logic, connector pinout and output recordDefines fixture, software, cycle time and validation responsibility
Quality recordsTraceability depth, certificates, inspection data and retention periodDefines data capture and shipment documentation
Commercial inputsPrototype and production quantities, forecast, consigned parts and delivery targetDefines material purchase, panelization, capacity and lead time

Send the controlled package to sales@bestpcbs.com. We will review the infusion pump PCB assembly, identify missing manufacturing or test inputs, and confirm the applicable PCB, component-sourcing, assembly, inspection and documentation scope before quotation.
